Kharin s.a.
Research of speed of main crossheadings
at building of deep mines
We investigate dependence of speed of
driving of main crossheading, located on horizon of the 2th stage of dissection
of deposit. In this case takes place considerable (in 3 and more than time)
reduction of length of crossheadings as compared to their sizes on horizons of
the 1th stage of dissection, especially on no-bottoms.
At specific gravity of time of driving of
making of main direction of horizon in general duration of works on dissection
and building of deposit by the 2th stage of dissection 0,6 takes place
following.
At time of building of horizon 108 months
(Table 1) and on condition of maintenance of speed of driving of drift (vs) at the level of 10 m/month, vent crossheading (vvkv) of 10 m/month, notches and arrivals (vz) also 10 m/month and ore court of main and flanking
barrel of 250 m3/month for providing of the set time of driving of
horizon it will be necessary to provide speed of driving of main crossheading
of 132 m/month, that appears very difficult and practically not realized,
having regard to both large area of cross-sectional of this type of making and
high fortress of breeds building is conducted in which.
Further, to some level, at low values
small change of rates of building of drift, at a maintainance at former level
of speeds of driving of other making
conduces to the fall-off of the required speed of driving of main crossheading.
At growth of speed of leadthrough of drift from 15 to 20 m/month and other
equal terms speed of driving of main crossheading goes down to 20,2 m/month or
in 6,53 time as compared to the case of vs = 10
m/month and in 1,4 time as compared to the case of vs = 15 m/month.
Here it should be noted that, as far as
growth of level of speed of driving of drift, other things being equal,
intensity of decline required for providing of building of horizon in the set
term of speed of driving of main crossheading at the equal intervals of growth
of speed of driving of drift (there is this interval of 5 m/month in our case)
will diminish. So, for example, at vs = 30 m/month speed of leadthrough of main
crossheading will be already only in 1,17 time below, than at vs = 25
m/month. By an especially model in that behalf there is a case of comparison at
vs = 45 m/month and vs = 50
m/month, when speed of driving of main crossheading goes down from 13,8 to 13,4
m/month or in 1,03 time.
Table 1
Speeds of building of the mountain making
Main crossheading, m / months |
Drift, m / months |
Vent crossheading, m / months |
Notches and arrivals, m / months |
Îre court of main barrel, m3 / months |
Îre court of flanking barrel, m3 / months |
Time of building of horizon is 108 months |
|||||
132 |
10 |
10 |
10 |
250 |
250 |
28,2 |
15 |
10 |
10 |
250 |
250 |
20,2 |
20 |
10 |
10 |
250 |
250 |
17,3 |
25 |
10 |
10 |
250 |
250 |
49,5 |
10 |
10 |
10 |
400 |
400 |
7,43 |
20 |
20 |
20 |
400 |
400 |
Time of building of horizon is 86,4 months |
|||||
107 |
30 |
10 |
10 |
250 |
250 |
74,8 |
35 |
10 |
10 |
250 |
250 |
61,1 |
40 |
10 |
10 |
250 |
250 |
14,7 |
20 |
20 |
20 |
250 |
250 |
11 |
25 |
25 |
25 |
250 |
250 |
Time of building of horizon is 43,2 months |
|||||
96,3 |
40 |
35 |
30 |
250 |
250 |
78,7 |
45 |
35 |
30 |
250 |
250 |
68,6 |
50 |
35 |
30 |
250 |
250 |
24,3 |
50 |
50 |
50 |
400 |
400 |
14,1 |
100 |
100 |
100 |
600 |
600 |
Time of building of horizon is 36 months |
|||||
115 |
45 |
50 |
50 |
250 |
250 |
94,8 |
50 |
50 |
50 |
250 |
250 |
43,1 |
50 |
50 |
50 |
400 |
400 |
29,9 |
100 |
100 |
100 |
250 |
250 |
21,7 |
100 |
100 |
100 |
400 |
400 |
18,8 |
100 |
100 |
100 |
600 |
600 |
In this connection it should be noted that
for maintenance technically of the acceptable to the certain terms of speed
driving of the most difficult making – main crossheading – expediently substantial
not increase of rates of leadthrough some one from a number other making of
horizon, but comparatively even, but not so high, change of level of driving of
all types of making.

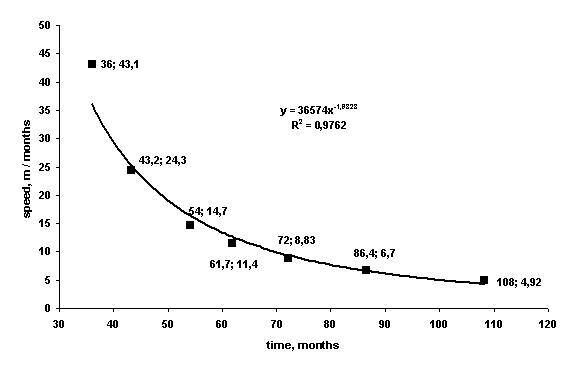

Fig. 1.
It is dependence of speed of main crossheading on time of building of horizon
Taking into account more high volume of
works on the leadthrough of a vent crossheading among other extensive making of
horizon it is necessary to mark large meaningfulness of this type of making for
providing of one or another level of driving of main crossheading. So, for
example, speed last at vs = 20 m/month, vvkv =
10 m/month and vz = 10
m/month there will be 20,2 m/month, but at combination of vs = 10 m/month, vvkv =
20 m/month and vz = 10
m/month it will be only vgkv =
15,7 m/month, and at vs = 10
m/month, vvkv = 10 m/month and vz = 20 m/month
there will be 20,2 m/month needed already considerably more high-rate of main
crossheading of 42 m/month obviously, that for providing of certain level of
driving of main crossheading the rates of leadthrough of a vent crossheading
are most essential, in less – notches.
