Экономические науки/8. Математические методы в экономике

Dr. Sci. (Econ.) Suvorova V.V., Cand. Sci. (Econ.) Kochevatkina E.F.,

Timarsuev M.V., Kudlovich D.V.

Balakovo institute of technical, technology and management

Вranch  of Saratov State Technical University

DEVELOPMENT AND IMPLEMENTATION OF INFORMATION AND COMPUTER COMPLEX FORTHE CONCEPT OF ACTIVE LEARNING

The Information and Computer Complex is a shell with a set of specialized tools for creatingof informational objects, describing of their properties, interconnections and algorithms of information processing, as well as the mechanism forthe interpretation of thesedescriptions which are used for the formalization of the calculation and graphical part of projects.

The aim of the development of the Information and Computer Complex is an automation ofproduction processes projection.

The implementation of the Information and Computer Complex which is used to solve problems of automatedprojection of productionprocesses includes aseries of successivestages of work(in Fig. 1).

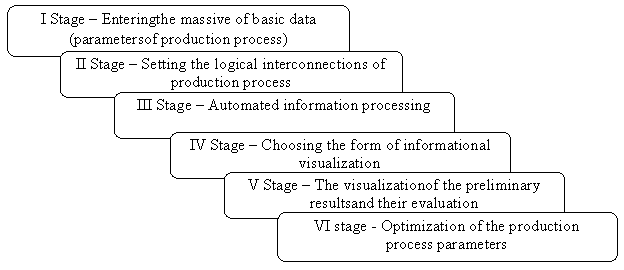

Figure 1 –Stages of automated projection in the Information and Computer Complex

Let us examine in detail every stage of the automated projectionof production processes implemented within the developed Information and Computer Complex.

The 1st Stage - Entering the massive of basic data (parametersof production process). At this stage a production process is being identifiedi.e. the complex of all actions of personnel and tools which are needed for an economical subject to make products, works or services is being determined. Based on it the module which corresponds to this production process is being chosen (in Fig. 2)

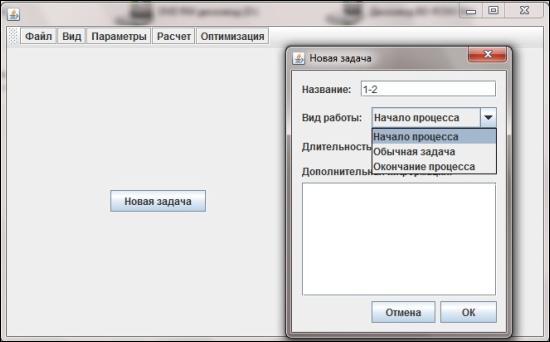

Figure 2 – the identification of the production process

Then the formulation of the problem begins and basic data which describes the production process, e.g. a type of work, duration, detailed description of production process technology, is being entered (in Fig. 3).

Figure 3 – Entering (input)thebasicdata

The 2nd Stage - Setting the logical interconnections of production process. Based on the input data the logical interconnections are set due topreviouslyidentifieda specifictype ofmanufacturing process. In other words,the sequence of works whichinvolve the studied production process is being formalized (in Fig. 4).

Figure 4 – Setting the logical interconnections

The result of this stage of working in the Information and Computer Complex is theinterpreted structure of the studied production process (in Fig. 5).

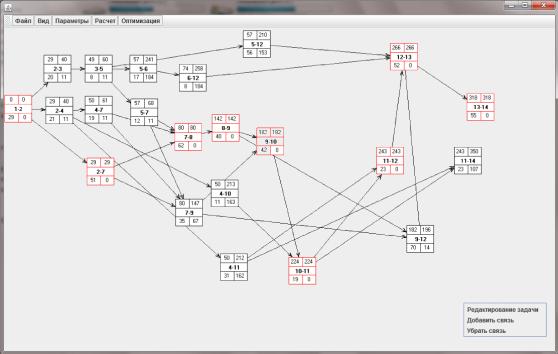

Figure 5 – The interpreted structure of the studied production process

Besides every element of the interpreted structure contains the information about parameters of a single work of the production process (duration of works, encoding, description of works which are performed). If it is necessary,these elements can be modified and/or supplemented(Fig.6).

Figure 6 – Editing the element of the interpreted production process structure

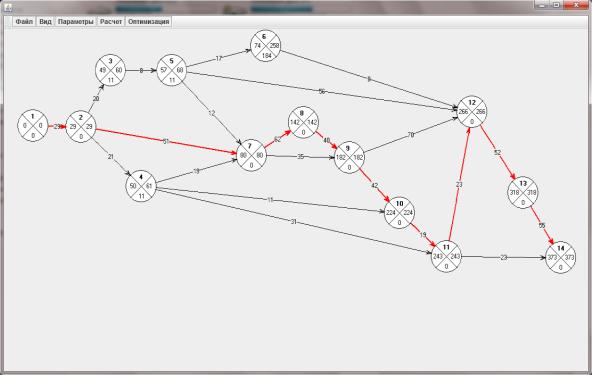

The 3rdStage - Automated information processing. This stage of work in the Information and Computer Complex provides automated calculation of time parameters of the studied production process (in Fig. 7).

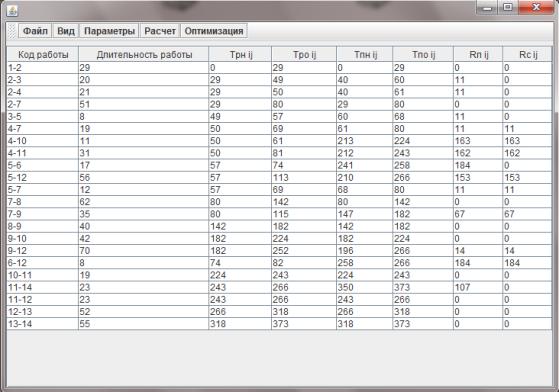

Figure 7 – The results of automated information processing of the studied production process

Based on data from fig. 7 there is a calculation of the parameters which characterize the production process at this stage of work in the information and computer complex.They are:

-            the critical way which describes the duration of works with absence of time reserves;

-            the early term of fulfillment of the event which determines the time period of performance of manufacturing operations without using the time reserves;

-            the late term of fulfillment of the event which fixes the duration of works with full using of time reserves;

-            full time reserve which allows to determine the amount of time which can be used to delay the performance of the initial work stage without violation of general termsof the production process;

-            free time reserve which represents the amount of time which can be used without any violation of early terms of the work performance.

The 4th Stage - Choosing the form of informational visualization. To analyze the data which has been resulted after processing the basic information it is necessary to present the production process graphically that allows to visualize the sequence of business operations which are involved into the production process. Options of the developed Information and Computer Complex allowto present the results of automated information processing in the studied production process which has been calculated at the previous stage as “a set of events”, “a sequence of works” or “a table”.

Presentation of the results of automated data processing as a set of events is more informative, i.e. it contains maximum amount of information and more suitable for a user (in Fig. 8).

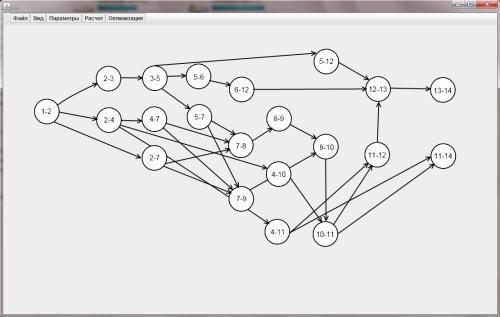

Figure 8 - Presentation of the production process as a setof events

As you can see, the presentation of the results of automated information processing as a complex of events involves the information output about sequence of interconnected technological operations, terms of the operation performing, time reservesand duration of the works.

After visualization of the automated information processing results as a sequence of works a user gets less informative form of data presentation but at the same time more suitable for editing and adding in case of changing the parameters and factors affecting  the production process (in Fig. 9).

Figure 9 – Presentation of the production process as a sequence of works

The tabular display of the automated information processing results allows to represent analytical data as a compact integrated system which provides more efficient way of generalization and analysis of the production process parameters (in Fig. 10).

The presenceof additional options allows user to adjust the interface individually.

Figure 10 - Presentation of the production process as a table

The 5th Stage - The visualizationof the preliminary resultsand their evaluation.The visualization of the results is being carried out as a project map which consists of ribbon  diagrams and the diagrams of parametric data forparticular parameters and the cumulative diagram which displays synergistic effect of the complex of given parameters (in Fig 11).

The disadvantages of existing organization of the production process are visualized on the original production project plan. So that “laydowns” show underutilization of existing resources and “spires” show the overload of used resources and the necessity of involving additional resources.

The identified shortcomings of the production process can be corrected with the developed byinformation and computer complex.

The 6th Stage - Optimization of the production process. Basing on the results of the analysis the optimization of existing production process is being performed. With menu command “Solution” a user adjusts the ribbon graphs and diagrams that leads to the distribution of existing production reserves (in Fig. 12).

Figure 11 – Basic card of the production process

The feature of choosing the optimal variant of production process is the lack of strict algorithm for solving the problem. Basing on it the optimization of the production process which is being realized in a traditional way represents non-formalized solution of the basic problem through choosing one from many other variants which have been obtained by the empirical method. This method suggests the examining a generous amount of production data combinations. Herewith the obtained result does not guarantee the optimal variant of production process.

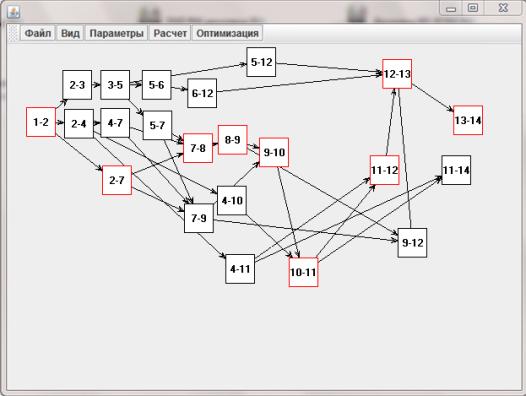

Figure 12 – Optimized production process card

The using of the information and computer complex to optimize the production process provides full automated solution process of the problem and minimizes the possibility of making a mistake which is caused by human factor.
